ToggleEurope’s Solar-Plus-Storage PPA Shift: What the New Hybrid Market Means
Why Hybrid Solar PPAs Are Gaining Ground in 2026—and What Solar EPCs, BESS Integrators, and Renewable Energy Developers Should Prepare For
Published: October 28, 2026 | SNOSECURE Renewable Energy & Infrastructure Insights
Imagine two solar power plants in Spain.
Both generate large amounts of electricity during sunny afternoons.
Both face periods when wholesale electricity prices fall sharply.
And both must manage the commercial consequences of producing electricity when the market needs it least.
But there’s one important difference.
Project A sells solar electricity as it is generated.
Project B combines solar generation with battery energy storage and can shift some electricity delivery into different hours.
The second project has more operational flexibility.
It may also have a more complex commercial agreement, additional investment requirements, and new technical risks.
This is one of the reasons Europe’s power purchase agreement (PPA) market is evolving.
According to LevelTen Energy’s Q3 2026 European PPA Price Index, hybrid renewable energy-plus-storage offers are gaining ground across European markets.
Spain provides an especially interesting example.
LevelTen reported a standalone solar PPA P25 price of approximately €30.93/MWh, compared with €48.00/MWh for hybrid PPA offers in Q3 2026.
But here’s what developers, EPC contractors, and energy buyers must understand:
These figures represent different commercial products. They should not be interpreted as a simple, like-for-like price premium created by adding a battery.
So what exactly is a hybrid solar PPA?
Why are developers combining solar PV with battery energy storage systems (BESS)?
And what does this market shift mean for the construction, operation, and protection of renewable energy assets?
Let’s explore.
1. October 2026: Europe’s Hybrid PPA Market Is Expanding
On October 23, 2026, PV Tech reported new European PPA market findings from LevelTen Energy.
The latest data highlights several developments.
- European standalone solar PPA prices rose 0.4% quarter-on-quarter on LevelTen’s Continental Index.
- The European solar index reached 0.86 relative to its Q3 2024 baseline.
- Hybrid PPA offers appeared across nine European markets in Q3 2026.
- Spain and Portugal accounted for nearly half of European hybrid offers.
- Spain’s standalone solar P25 offer price was approximately €30.93/MWh.
- Spain’s hybrid P25 offer price reached €48.00/MWh.
- Germany’s hybrid P25 offer price fell 12.7% quarter-on-quarter to approximately €65.50/MWh.
These figures indicate that the market is becoming more diverse.
Developers are no longer considering only how much renewable electricity a project can generate.
They are increasingly considering when electricity can be delivered, how market risks are allocated, and whether storage can improve the commercial value of the generation profile.
Why the Spanish Figures Matter
Spain has experienced strong solar deployment, creating increasing competition among generators during sunny hours.
When many solar plants produce electricity simultaneously, wholesale prices can weaken.
This reduces the value captured by some solar generators.
Adding storage may allow a project to shift selected energy deliveries toward higher-value periods.
But the reported €48/MWh hybrid benchmark is not directly comparable with the €30.93/MWh standalone solar benchmark without understanding contract structure.
A hybrid agreement may include different delivery obligations, battery dispatch rights, risk allocation, or product characteristics.
The important trend is not simply that one quoted price is higher. It is that developers and buyers are increasingly negotiating more flexible renewable electricity products.

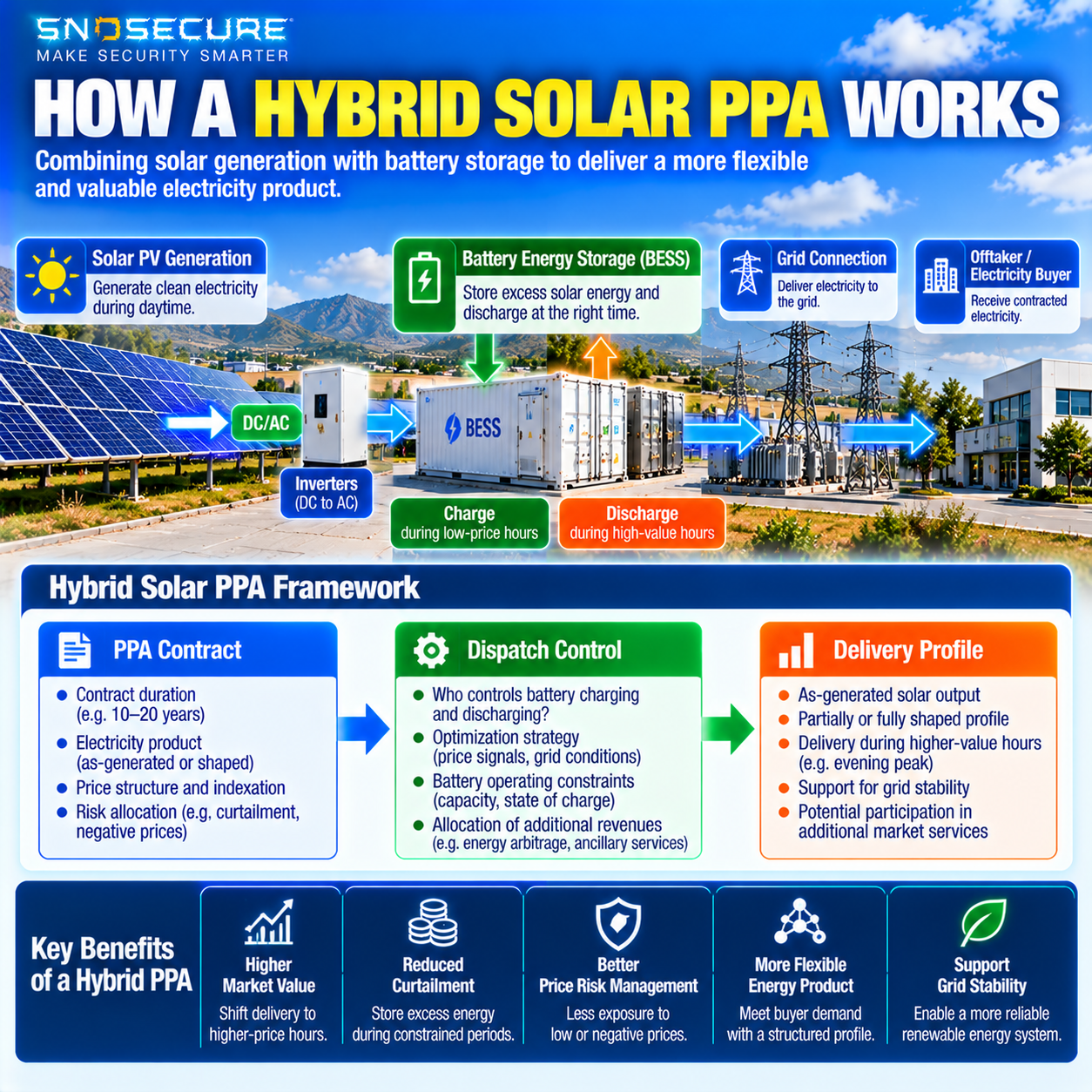

2. What Is a Hybrid Solar PPA?
A power purchase agreement is a contract governing the sale and purchase of electricity, usually over an agreed period.
A traditional solar PPA commonly relates to electricity generated by a solar photovoltaic project.
A hybrid solar PPA involves a renewable energy project combined with energy storage, often a co-located battery energy storage system.
However, there is no single universal hybrid PPA structure.
The exact arrangement depends on the project, electricity market, grid connection, and contract terms.
Traditional Solar PPA
A solar PV plant produces electricity when sunlight is available.
Under an as-generated or pay-as-produced structure, the buyer receives or financially settles electricity according to the agreed generation profile.
The electricity output is largely determined by solar conditions.
Solar-Plus-Storage Hybrid PPA
A solar PV plant operates alongside a battery.
Depending on the arrangement, the battery may:
- Store some solar-generated electricity
- Shift delivery to later hours
- Support a more predictable contracted output profile
- Reduce exposure to certain low-price periods
- Help manage selected curtailment events
- Participate in additional market services where permitted
The contract must define how these capabilities are valued and who controls them.
Three Important Commercial Questions
Who controls battery dispatch?
The developer, energy buyer, optimizer, or another party?
What exactly is being sold?
As-generated electricity, a shaped delivery profile, firmed supply, or another structured product?
Who receives the battery’s additional revenue?
The project owner, offtaker, battery operator, or a combination?
These questions can materially change the economics of the agreement.
For B2B stakeholders, a hybrid PPA is not simply a conventional solar PPA with a battery added to the site.
It is an electricity product with additional operational flexibility and commercial complexity.

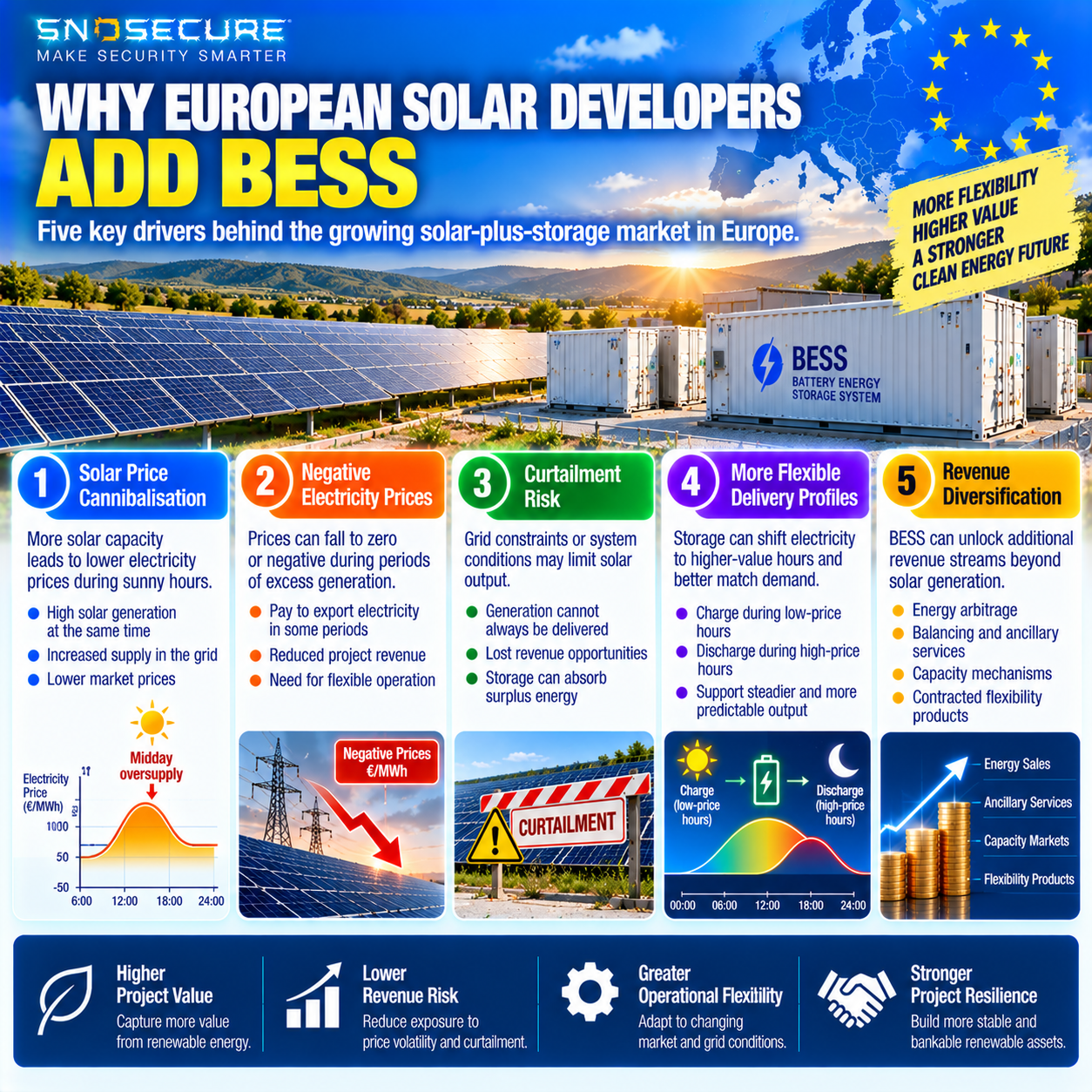

3. Why Are European Solar Developers Adding BESS?
There are several reasons.
Reason 1: Solar Price Cannibalisation
Solar generation is concentrated during daylight hours.
As installed solar capacity increases, electricity supply during sunny periods can become abundant.
When this happens, market prices during solar production hours may decline.
This is often called solar price cannibalisation.
A solar project may generate substantial electricity but earn less revenue per megawatt-hour during those periods.
Battery storage offers a potential way to shift some energy into different delivery hours.
Reason 2: Negative Electricity Prices
In some European electricity markets, wholesale prices can become negative during periods of excess generation or limited demand.
Depending on market arrangements and contractual terms, this can create challenges for generators.
Storage can provide an alternative to immediate export when charging is technically and commercially feasible.
However, batteries do not eliminate negative-price exposure automatically.
The result depends on storage capacity, state of charge, dispatch rules, efficiency losses, and contract design.
Reason 3: Curtailment Risk
Curtailment occurs when available generation cannot be delivered or is instructed to reduce output.
Possible causes include:
- Network constraints
- Grid congestion
- System balancing requirements
- Local infrastructure limitations
- Market-related operational decisions
A co-located battery may absorb some otherwise-curtailed energy.
But this depends on available charging capacity, grid rules, connection design, and the duration of the curtailment event.
Reason 4: More Flexible Delivery Profiles
Corporate electricity buyers may prefer energy products that better match their consumption patterns.
Solar generation alone does not necessarily align with evening electricity demand.
Battery storage can help reshape delivery, subject to the contracted product and available stored energy.
Reason 5: Project Revenue Diversification
In some markets, BESS can access multiple value streams, potentially including:
- Energy arbitrage
- Balancing services
- Ancillary services
- Capacity mechanisms
- Contracted flexibility services
Revenue stacking is not guaranteed.
Eligibility, market rules, operational restrictions, and contractual rights must be assessed.
The commercial case for solar-plus-storage is strongest when the value of additional flexibility exceeds the costs and risks of providing it.

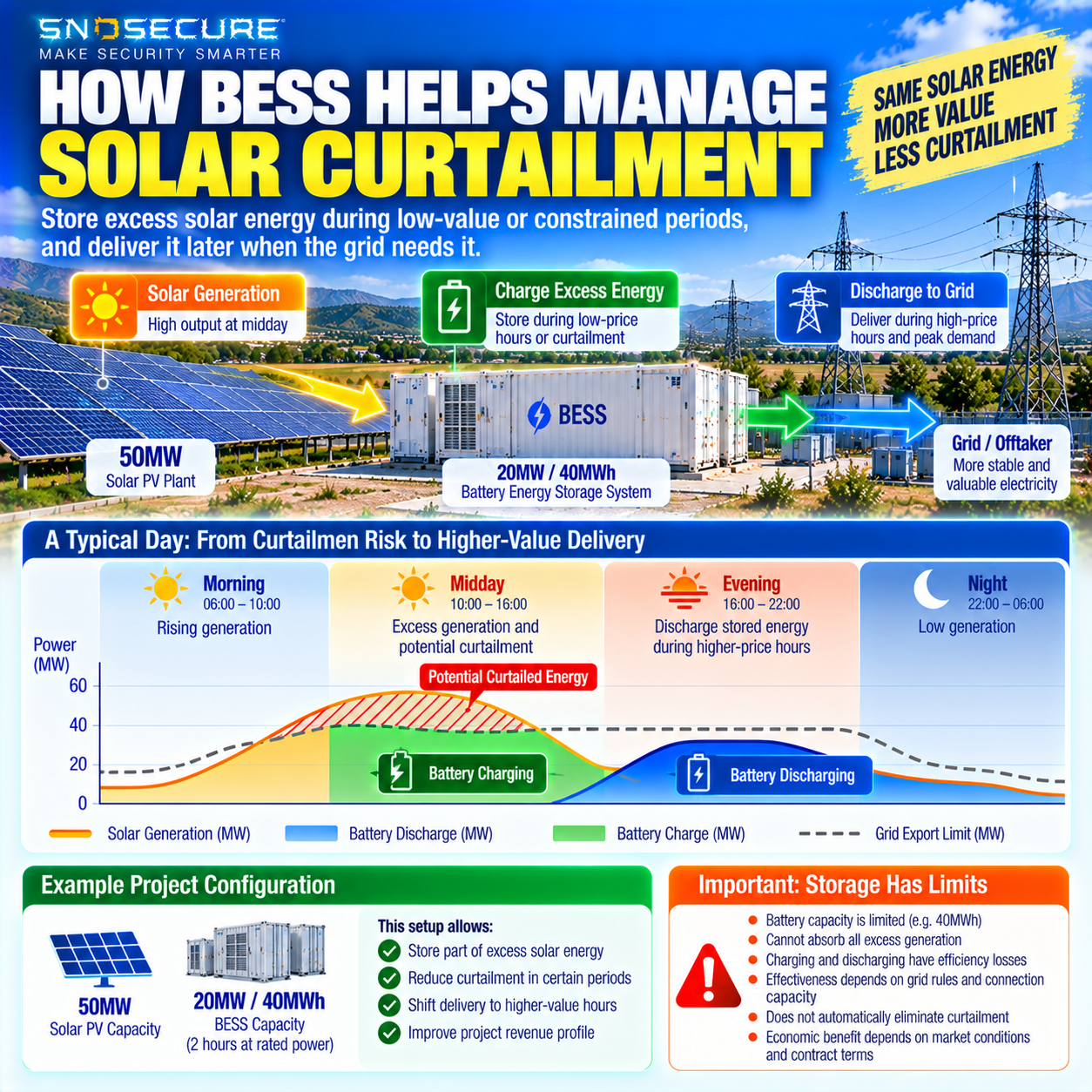

4. How Solar-Plus-Storage Helps Manage Curtailment
Let’s consider a simplified example.
A solar farm produces more electricity at midday than can be economically exported or accepted by the grid.
Without storage, some generation may be curtailed.
With a battery, the operator may be able to charge the BESS using some of that energy.
Later, when conditions permit, the battery can discharge.
Illustrative Example
Assume a solar facility has:
- 50MW solar PV capacity
- 20MW / 40MWh BESS
- A two-hour battery discharge duration at rated power
During a period of excess solar generation, the battery may charge, provided it has sufficient available capacity and the electrical configuration allows it.
It can then discharge some stored energy during a later period.
However, the battery cannot absorb unlimited surplus electricity.
Once it reaches its state-of-charge limit, additional surplus may still be curtailed.
Charging and discharging also introduce efficiency losses.
Important Technical Limitations
Battery storage does not automatically eliminate curtailment.
The actual benefit depends on:
Battery duration: How long can the system charge or discharge?
Battery power: How quickly can it absorb surplus electricity?
State of charge: Is there room available when curtailment occurs?
Grid connection: Are charging and exporting permitted under the relevant connection agreement?
Dispatch optimization: Does the control strategy anticipate low-price or constrained periods?
Contract terms: Who benefits financially from avoiding curtailment?
For EPCs and developers, these details should be evaluated during project design, not after commissioning.

5. Hybrid PPA vs Standalone Solar PPA: What’s the Difference?
| Factor | Standalone Solar PPA | Solar + BESS Hybrid PPA |
|---|---|---|
| Main asset | Solar PV | Solar PV + battery storage |
| Generation profile | Sunlight-dependent | Can be partially reshaped |
| Dispatch flexibility | Limited | Greater, within BESS constraints |
| Curtailment management | Limited without flexibility | Potentially improved |
| Delivery structure | Often as-generated | May be shaped or structured |
| Hardware complexity | Lower | Higher |
| Capital requirements | Solar-related | Solar plus storage infrastructure |
| Operational requirements | PV monitoring and maintenance | PV + BESS + control integration |
| Contract complexity | Often simpler | More dispatch and risk provisions |
| Asset monitoring needs | PV site and electrical assets | PV, BESS, shared infrastructure and controls |

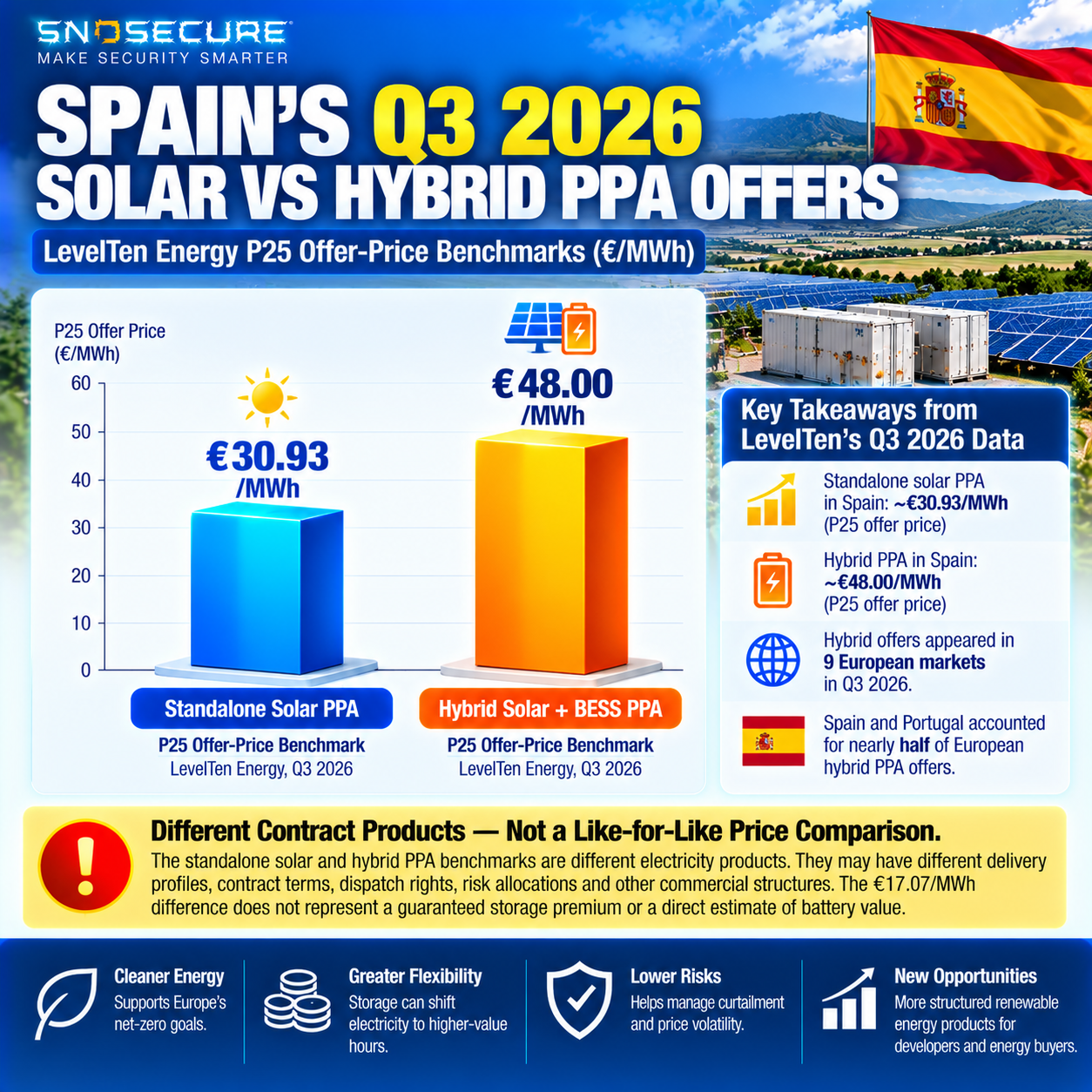

Why €30.93/MWh and €48/MWh Are Not Directly Comparable
The Q3 2026 Spanish figures represent LevelTen’s reported P25 offer-price benchmarks for two different PPA categories.
The numerical difference is:
€48.00 − €30.93 = €17.07/MWh
But that difference should not be presented as:
- The guaranteed value of adding a battery
- A fixed storage premium
- Additional project profit
- A universal hybrid PPA uplift
- The incremental cost of BESS
Those conclusions would require a controlled comparison of otherwise equivalent projects and contracts.
Relevant variables include delivery hours, project location, tenor, volume, shape, battery dispatch rights, negative-price provisions, guarantees of origin, and risk allocation.
A hybrid PPA price should be evaluated as the price of a defined electricity product—not as a standalone solar price plus a universal battery surcharge.
6. Spain, Portugal, and Germany: Different Hybrid PPA Opportunities
Europe is not a single electricity market.
Each country has different grid conditions, renewable generation profiles, storage economics, and contract structures.
Spain: Solar Saturation and Capture-Price Pressure
Spain’s large solar generation portfolio has increased pressure on midday electricity prices.
Developers are increasingly evaluating storage to improve flexibility and manage commercial risks.
The Q3 2026 figures highlight the challenges facing standalone solar economics.
Portugal: Growing Hybrid Interest
Portugal also features prominently in LevelTen’s hybrid offer data.
Its renewable energy mix, market integration with Iberia, and project-specific grid conditions create opportunities for solar-plus-storage structures.
Germany: Flexibility and Shaped Power Demand
Germany faces its own challenges involving renewable generation growth, negative-price periods, and changing demand for structured energy products.
LevelTen’s Q3 2026 data showed German hybrid PPA offer prices declining quarter-on-quarter, illustrating that storage integration does not guarantee rising PPA prices.
What Developers Should Learn
Avoid using one European country’s PPA benchmark as the basis for another market’s investment decision.
A successful hybrid project requires country-specific analysis of:
- Electricity price profiles
- Grid connection conditions
- Storage market participation
- Permitting
- Battery economics
- Revenue uncertainty
- Offtake agreement terms

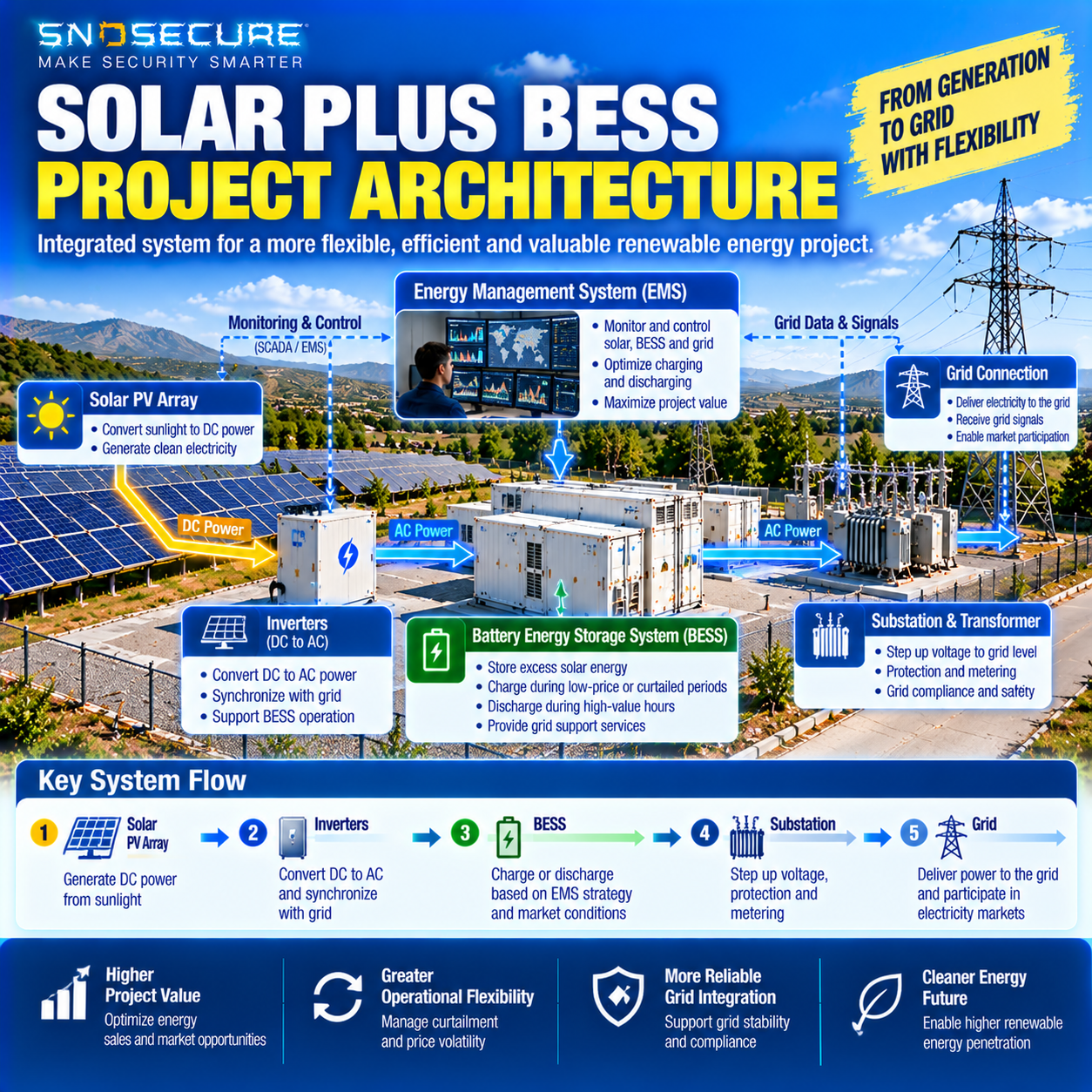

7. How Hybrid PPAs Change Solar EPC Project Requirements
The transition from standalone PV to solar-plus-storage introduces additional engineering work.
For Solar EPC contractors, the project may now involve two major energy systems operating together.
Electrical Integration
Depending on architecture, projects may require:
- Additional power conversion equipment
- Battery inverters
- Medium-voltage infrastructure
- Protection coordination
- Metering arrangements
- Communication networks
- Energy management systems
Battery Infrastructure
BESS installations introduce requirements involving:
- Battery enclosures or containers
- Thermal management
- Fire detection and protection
- Electrical isolation
- Access control
- Manufacturer-specific safety systems
Controls and Communications
A hybrid project may need coordinated operation among:
Solar Inverters → Energy Management System → BESS → Grid Connection → Market Optimizer
Reliable communication and system integration are essential.
Construction Coordination
Hybrid projects can involve more contractors, deliveries, commissioning stages, and high-value equipment.
This creates additional requirements for construction planning and site management.
For EPCs, the challenge is no longer only installing solar panels efficiently.
It is delivering an integrated energy asset that operates reliably under more complex technical and commercial requirements.

8. Why Hybrid Solar and BESS Projects Need Better Site Visibility
As projects become more complex, operators may need greater visibility across multiple physical areas.
These can include:
- Solar panel fields
- Battery container zones
- Substations
- Grid connection points
- Construction entrances
- Equipment storage areas
- Internal access roads
- Perimeter gates
Operational telemetry from SCADA, EMS, and BMS systems remains essential.
But electrical measurements do not always explain what is physically happening at the site.
For example:
A remote alarm indicates an unexpected equipment-area access event.
An operator may need to verify whether maintenance personnel, contractors, or an unauthorized visitor entered the area.
Video surveillance can provide additional visual context.
The Role of Security Cameras
A properly designed site surveillance system can support:
Access Verification
Confirming activity near gates, entrances, and restricted areas.
Construction Monitoring
Providing visual records of site activity, deliveries, and equipment movement.
Perimeter Security
Helping detect or investigate unauthorized entry.
Remote Visual Inspection
Allowing authorized personnel to check selected site conditions without an immediate site visit.
Incident Review
Supporting investigation of security-related events.
Importantly, ordinary security cameras are not substitutes for certified fire detection, BESS thermal monitoring, SCADA, BMS, or other safety-critical systems.
Their role is complementary physical security and visual observation.
9. Solar 4G Cameras for Remote Renewable Energy Projects
Not every solar or BESS project has a fully developed communications infrastructure during construction.
Some sites may have:
- Temporary site offices
- Limited broadband connectivity
- Remote access roads
- Unpowered equipment storage areas
- Temporary perimeter gates
- Expanding construction zones
In these circumstances, solar-powered 4G cameras may provide a flexible surveillance option.
Potential Advantages
Independent Power
A solar panel and battery can support operation without a dedicated local power cable, when properly Battery Sizing.
Cellular Connectivity
4G can provide remote access where compatible network coverage is available.
Flexible Installation
Cameras may be relocated as construction progresses.
Remote Alerts
Motion or human-detection events can be transmitted to authorized personnel.
PTZ Monitoring
Motorized cameras can inspect selected areas, subject to their coverage and power limitations.
Important Limitations
Solar 4G cameras require careful evaluation of:
- Cellular signal strength
- LTE band compatibility
- SIM and data plans
- Winter solar irradiation
- Battery autonomy
- Recording strategy
- Night vision energy demand
- Cybersecurity and access permissions
For permanent high-security installations, professionally engineered wired power, networking, redundancy, and centralized video management may be more appropriate.
Solar 4G cameras are useful tools for selected remote and temporary monitoring applications—not a universal replacement for a complete industrial security system.

10. AOV, PIR, and PTZ: Choosing the Right Recording Strategy
Different areas of a renewable energy project may require different surveillance approaches.
PIR Motion-Triggered Recording
A PIR-based camera can remain in a low-power state and record when relevant motion is detected.
Potential applications include:
- Low-traffic perimeter points
- Remote gates
- Temporary equipment areas
Advantages may include lower energy consumption.
However, event-only recording can provide less pre-event context.
AOV Low-Frame-Rate Recording
AOV systems may maintain a low-frame-rate recording timeline between higher-frame-rate events.
Potential applications include:
- Construction access points
- Equipment delivery areas
- Locations requiring more event context
AOV may offer broader timeline coverage, but can consume more energy and storage than deep-standby PIR recording.
AOV and PIR are not mutually exclusive: some cameras combine low-frame-rate recording with PIR event detection.
PTZ Surveillance
PTZ cameras allow operators or automated systems to change viewing direction.
Potential applications include:
- Large equipment yards
- Access roads
- Wide construction areas
However, a single PTZ camera cannot necessarily observe all directions simultaneously.
Choosing by Application
| Monitoring Area | Potential Camera Strategy |
|---|---|
| Remote low-traffic gate | PIR solar 4G |
| Construction entrance | AOV or event-based recording |
| Large equipment yard | PTZ surveillance |
| BESS container perimeter | Fixed coverage plus suitable detection |
| Temporary material storage | Solar 4G with local recording |
| Permanent critical infrastructure | Engineered fixed-camera network with appropriate redundancy |
The correct selection depends on site-specific risk assessment, regulatory requirements, network availability, and operational priorities.
11. The Hidden Cost of Poor Monitoring During Solar + BESS Construction
Large renewable energy projects involve expensive equipment and multiple contractors.
Potential physical-security risks include:
- Theft of materials
- Unauthorized site access
- Equipment vandalism
- Damage during construction
- Unrecorded delivery disputes
- Limited visibility of remote work areas
Video surveillance may help deter some activity and support investigation.
But its commercial value should be assessed realistically.
For example, a camera may help document an incident, but it cannot guarantee theft prevention.
An alert may support faster response, but response time depends on personnel and procedures.
What EPCs Should Evaluate
Site Risk
Which areas require monitoring?
Construction Duration
How long will temporary security equipment be needed?
Power Availability
Is fixed power available?
Connectivity
Can the site support Wi-Fi, wired networking, or 4G?
Recording Requirements
Are event clips sufficient, or is broader recording coverage required?
Security Integration
Who receives alerts, reviews footage, and responds?
Data Governance
How are video access, retention, privacy, and cybersecurity managed?
Security cameras should be selected as part of a broader site protection plan.
12. What BESS Integrators Should Look for in a Surveillance Solution
Battery energy storage projects have specific site-security considerations.
High-value equipment, restricted access areas, and remote operations create requirements that may differ from residential camera installations.
Key Evaluation Criteria
1. Outdoor Durability
Appropriate enclosure protection and temperature performance.
2. Recording Reliability
A suitable recording strategy and storage architecture.
3. Nighttime Visibility
Image quality under actual site lighting conditions.
4. Remote Connectivity
Stable network access and secure remote viewing.
5. Power Autonomy
Measured energy consumption and realistic solar charging assumptions.
6. Integration
Compatibility with the site’s broader security and operations architecture where required.
7. Cybersecurity
Access control, firmware maintenance, and secure communications.
8. Maintenance Requirements
Battery replacement, cleaning, firmware updates, and long-term support.
9. Compliance
Applicable product, installation, radio, electrical, privacy, and site-specific requirements.
10. Supplier Support
Documentation, warranty terms, testing, and project customization.
For European projects, equipment selection should also account for relevant national and EU requirements.

13. How the Hybrid PPA Shift Creates Opportunities for Security Suppliers
The growth of solar-plus-storage projects does not automatically translate into a proportional increase in camera demand.
However, hybrid projects may create new physical-security and monitoring requirements because they add equipment, construction activity, and operational interfaces.
This can create opportunities for suppliers serving:
Solar EPC Contractors
Temporary construction monitoring and remote site access.
BESS System Integrators
Visual security coverage around battery installations.
Renewable Energy Developers
Site protection during development and construction.
Independent Power Producers
Operational site security and incident verification.
O&M Service Providers
Remote visual checks and selected maintenance-support workflows.
Security System Integrators
Project-specific surveillance design and deployment.
The B2B Opportunity
For surveillance camera manufacturers, the opportunity is to offer solutions matched to actual renewable energy project conditions.
That may include:
- Solar-powered 4G cameras
- PTZ cameras
- AOV recording options
- Outdoor surveillance systems
- OEM/ODM customization
- Project-specific hardware configurations
But technical suitability must always be verified.
A camera designed for residential monitoring should not automatically be presented as suitable for critical infrastructure.
14. How SNOSECURE Supports Remote Solar and Infrastructure Monitoring
At SNOSECURE, we manufacture surveillance camera solutions for international B2B customers.
Our product areas include:
- Solar 4G security cameras
- Solar Wi-Fi cameras
- AOV surveillance solutions
- PTZ security cameras
- Outdoor monitoring products
- OEM/ODM camera manufacturing
Our manufacturing background includes:
20 years of manufacturing experience
6 production lines
12,000 m² factory
For renewable energy contractors, distributors, and security system integrators, camera selection should begin with the application.
A temporary construction entrance may require a different system from a permanent BESS facility.
A remote solar farm may prioritize low-power operation and cellular connectivity.
A large equipment yard may require multiple fixed cameras or PTZ monitoring.
Our approach is to discuss the required product configuration, power strategy, recording functions, connectivity, and customization scope before recommending a suitable camera solution.
Product availability, certifications, compatibility, and project-specific capabilities should be confirmed for the selected model.
Looking for a Surveillance Camera Manufacturing Partner?
If your company supplies renewable energy projects or industrial security systems, SNOSECURE welcomes discussions about solar 4G, Wi-Fi, AOV, PTZ, and OEM/ODM surveillance solutions.
15. Frequently Asked Questions
What is a hybrid solar PPA?
A hybrid solar PPA is an electricity offtake agreement associated with solar generation and battery energy storage. Its structure can include different delivery profiles, dispatch rights, and risk-sharing arrangements.
Why are hybrid PPAs growing in Europe?
Developers and buyers are responding to solar price cannibalisation, curtailment risk, demand for shaped electricity products, and improving battery economics.
What was Spain’s solar PPA price in Q3 2026?
LevelTen reported a standalone solar P25 offer-price benchmark of approximately €30.93/MWh for Spain.
What was Spain’s hybrid PPA price in Q3 2026?
LevelTen reported a hybrid P25 offer-price benchmark of approximately €48.00/MWh.
Does this mean battery storage adds €17.07/MWh of value?
No. The difference is between two categories of offer-price benchmarks. It is not a controlled estimate of battery value, cost, or project profit.
Can BESS eliminate solar curtailment?
Not necessarily. Storage can absorb some excess generation when charging capacity, operating conditions, and grid rules permit, but it cannot eliminate every curtailment event.
How does BESS help with electricity price volatility?
Storage may allow operators to shift energy delivery between periods, subject to market rules, efficiency losses, and contractual obligations.
What does solar-plus-storage mean for EPC contractors?
It introduces additional electrical integration, battery infrastructure, controls, commissioning, safety, and coordination requirements.
Why do hybrid solar projects need security cameras?
Cameras can support access verification, perimeter security, construction monitoring, remote visual inspection, and incident review.
Can solar 4G cameras be used at BESS sites?
They may be suitable for selected remote or temporary monitoring tasks when properly specified. They do not replace certified safety systems or a complete industrial security architecture.
Conclusion: Europe’s Hybrid PPA Shift Is About Flexibility, Not Just Higher Prices
The Q3 2026 LevelTen data highlights an important development in Europe’s renewable energy market.
Solar-plus-storage PPAs are becoming more prominent.
Developers are responding to changing electricity price profiles, curtailment risks, and demand for more flexible energy products.
But the transition is not simply about attaching batteries to solar projects.
It involves new contract structures, dispatch strategies, grid considerations, engineering requirements, and operational risks.
For Solar EPCs, BESS integrators, and renewable energy developers, success increasingly depends on integrating multiple systems effectively.
And as renewable energy projects become more complex, physical security and remote visual monitoring remain important supporting considerations.
The future of European solar is not only about generating more electricity. It is about delivering energy more intelligently—and operating the assets behind it more reliably.
SNOSECURE — MAKE SECURITY SMARTER.
Website: https://camhiprocam.com/
Email: simple@camhiprocam.com
WhatsApp: +86-185-6568-6066
Sources and Further Reading
LevelTen Energy — Q3 2026 European PPA Price Index (October 22, 2026)
https://www.leveltenenergy.com/post/q3-2026-ppi
PV Tech — European Solar PPA Prices Up 0.4% in Europe and 4.9% in the US (October 23, 2026)
https://www.pv-tech.org/european-solar-ppa-prices-up-0-4-europe-4-9-us/
Renewables Now — Operational Projects Now Make Up 40% of Europe’s PPA Offers (October 22, 2026)
PV Tech — LevelTen Publishes Hybrid Index to Reflect European Solar-Plus-Storage Shift (August 12, 2026)
Market figures are sourced from LevelTen reporting and associated coverage. The Spanish benchmarks refer to P25 offer prices rather than a representative average of executed PPA contracts. Engineering examples are illustrative.
